Interior Painting • Production Rates • Estimating

How to Estimate Interior Paint Jobs

Estimating Interior Wall Painting by SERVVIAN® Posted on 02-08-2022

It is time to learn the value of production rates when estimating interior paint work. Year after year your costs may change, but production timing is what keeps the estimate grounded in reality. The key is simple: track each item of service separately, assign the right production rate to that item, and then convert the total hours into price using your company’s hourly sell rate inside BreakEven PLUS™.

Production Rates Create Accurate Interior Estimates

Interior painting estimates should be built from task-specific production timing, not from one blended number for the entire job. Every item of service has its own speed. Pole sanding is not the same as spot-patching. Spot-priming is not the same as cutting and rolling walls. Laying down drop cloths is not the same as cleanup and demobilizing.

That is why strong estimating requires you to keep records for each item of service your company performs, along with production timing and application style, whether brush, roll, spray-back-roll, or spray.

Best practice: Do not roll multiple service items together into one production rate. Each task should stand on its own so labor hours remain visible, measurable, and defendable.

Why Each Item Needs Its Own Production Rate

When pricing interior wall painting, each item has its own production rate or speed. This matters because prep, paint application, access, and cleanup all affect labor differently. A repaint with cutting-in at ceilings, corners, and trim lines will not produce at the same speed as a new construction spray job.

Pole Sanding

Surface prep like pole sanding may move quickly on broad wall areas, but it still needs its own production number and should never be blended into patching or finish painting.

Spot-Patching

Spot-patching is slower and more variable than general sanding. It requires separate tracking because repair intensity changes labor demand significantly.

Spot-Priming

Spot-prime work should be estimated independently. It is its own service item and should not be hidden inside topcoat production rates.

Mobilizing and Demobilizing

Laying drop cloths, protecting floors, staging tools, and cleaning up at the end are labor events that must be priced intentionally.

Core Interior Painting Production Examples

Below are example production speeds often used as starting points. Your best production rates should always come from internal tracking of your own crews under your own field conditions.

Brush/Roll 8' Walls
200 SF/hr
Brush/Roll 17' Walls
150 SF/hr
Roll 8' Walls Only
400 SF/hr
Spray Only
800 SF/hr

Rolling open 8-foot walls can move much faster than repaint brush-and-roll work because cutting-in changes the production speed. On new construction spray jobs, pure spraying can be faster, but adding backroll can cut production roughly in half.

Production Speeds by Task Type

These example rates help show how production changes depending on the work method. They are not universal standards. They are examples to help estimators think in separate service items rather than one blended wall-painting number.

Spray only on new construction800 SF/hr
Spray + backroll400 SF/hr
Roll only on 8' walls400 SF/hr
Brush + roll 8' repaint walls200 SF/hr
Brush + roll 17' walls150 SF/hr
Field reality: The use of ladders can slow productivity by 25%–50% in many cases. Height, access, staging, and repositioning all affect the real production number.

Do Not Forget Mobilization and Cleanup

Interior paint estimates often miss time because mobilization and demobilization are treated like they are “included somewhere.” They should be estimated intentionally.

Drop Cloths / Floor Protection

Laying down drop cloths can be estimated at around 1400 SF per hour as a mobilization task, depending on layout and protection needs.

Daily Setup and Reset

Moving tools, staging materials, repositioning equipment, and protecting adjacent areas all affect labor and should not be ignored.

Cleanup / Demobilizing

Cleanup time is part of demobilizing. If it takes labor to leave the project ready for turnover, it belongs in the estimate.

When these items are skipped, the estimate may look competitive but the labor burden shows up later in the field.

Example Estimate Structure Using BreakEven PLUS™

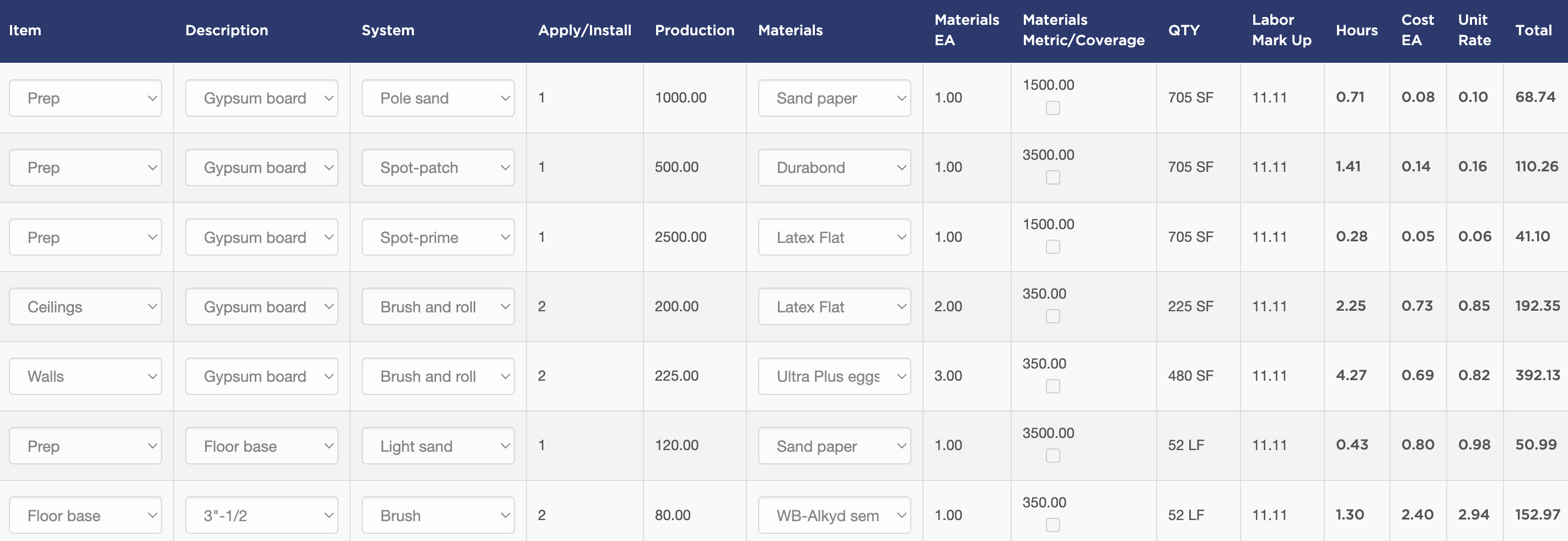

The screenshot example below reflects the logic estimators should follow inside BreakEven PLUS™. Each row is treated as a distinct service item with its own application count, production speed, material setup, hours, and cost result.

Item of Service Example Production Example Quantity Example Hours Why It Stands Alone
Pole sand 1000 SF/hr 705 SF 0.71 hrs Prep speed is different from patching, priming, and finish coats.
Spot-patch 500 SF/hr 705 SF 1.41 hrs Repair intensity creates a slower and more variable labor demand.
Spot-prime 2500 SF/hr 705 SF 0.28 hrs Priming is its own application event and should not be blended into topcoat speed.
Ceilings brush and roll 200 SF/hr 225 SF 2.25 hrs Ceilings have a different production pattern than walls and trim-related repaint work.
Walls brush and roll 225 SF/hr 480 SF 4.27 hrs Wall finish work must account for cut-in, rolling, and field conditions.
Floor base light sand 120 LF/hr 52 LF 0.43 hrs Trim and base work should not be buried inside wall-painting averages.
Floor base brush 80 LF/hr 52 LF 1.30 hrs Baseboard finish work is slower and more detailed than broad wall rolling.

The values above reflect the estimating logic shown in your screenshot and illustrate why task separation matters. The exact rates your company uses should come from your own internal production tracking.

How the Hours Become Price

Once you know how many hours each item of service will take, add the total man-hours together and multiply them by your company’s hourly sell rate. That is where BreakEven PLUS™ becomes especially useful.

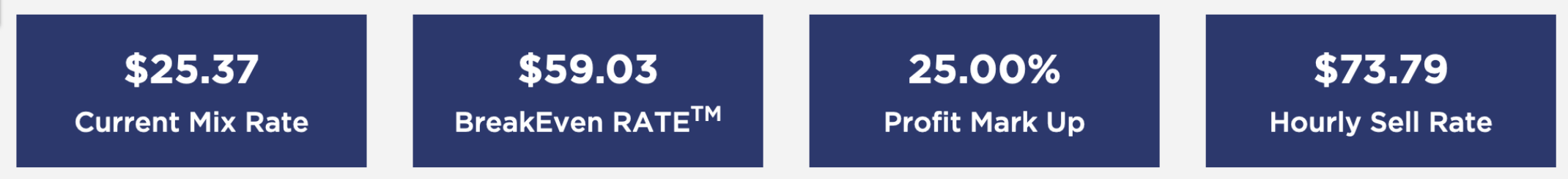

BreakEven PLUS™ Cost Setup helps establish your custom average hourly sell rate as well as sell rates for individual painters. That gives you a more realistic pricing structure than using one generic labor number for every situation.

Estimating workflow: Measure quantities → assign each service item its own production rate → calculate hours by item → total the hours → apply your hourly sell rate → add materials and other direct costs.

Best Practices for Interior Paint Estimates

  • Track production timing internally for each item of service your company performs
  • Separate prep, repairs, priming, finish coats, protection, and cleanup into distinct estimate lines
  • Adjust production for height, ladder work, staging, and repaint cutting-in conditions
  • Do not treat spray, roll, brush-and-roll, and spray-back-roll as interchangeable methods
  • Use internal historical data as your best source of production truth

All of your best production rates come from your own internal tracking. That is what makes the estimate less theoretical and more reliable over time.

Estimate Interior Paint Jobs with More Control

Interior painting estimates become more accurate when each item of service is treated as its own measurable production event. Prep work, patching, spot-priming, wall application, ceiling work, base work, mobilization, and cleanup all deserve their own labor logic.

SERVVIAN® BreakEven PLUS™ helps contractors turn that production logic into a more disciplined estimate by connecting quantities, rates, hours, materials, and sell-rate pricing in one structured workflow.
