Increase Construction Profits with Better Breakeven Visibility

To increase construction profits, contractors need more than a markup percentage at the end of an estimate. They need a clearer view of breakeven, burden, fringe, overhead, G&A, and pricing logic before a bid is ever submitted.

To increase construction profits, contractors need more than a markup percentage at the end of an estimate. They need a clearer view of breakeven, overhead, burden, fringe, and pricing logic before a bid is ever submitted. When those cost layers are modeled correctly, profit becomes more visible, more defendable, and easier to control.

Increasing service and construction profits can be daunting when costs keep changing and hidden overhead keeps distorting pricing. Many contractors try to solve that problem by adding profit markup alone, but markup is only as accurate as the breakeven underneath it. When breakeven is incomplete, the result can be understated hourly sell rates, reduced margin, and teams working harder for less.

One of the most common statements heard from smaller operators is: “I do not really have overhead. I operate out of my truck.” But even in the embryo stage of a business, overhead still exists. There is estimating time, customer service, scheduling, management effort, administrative follow-up, software, phones, insurance, and office-related work that may not be visible in the field. Those costs do not disappear because they are not tracked. They simply become hidden and unrecovered.

BreakEven PLUS™ with FALIB® reporting helps at the small, mid-size, and enterprise level by giving contractors a more structured way to forecast budgets, recover administration and management time, and price work from a more complete labor cost stack. That matters for owner-operators running lean, but it also matters for larger organizations where indirect layers, operations, and support structures become even harder to see clearly.

How to Increase Construction Profits with Better Breakeven Visibility

To increase construction profits consistently, cost truth has to come first. That means understanding the full labor stack before markup is applied. BreakEven PLUS™ does not treat profit like a final spreadsheet row. It helps model labor burden, fringe, operations, overhead, G&A, and related support structure first so the final profit expression is built on something more reliable.

Small Contractor / Owner-Operator

Recover time that is often given away for free, including estimating, office work, customer service, and management effort that still exists even when the business is being run from the truck.

Mid-Size Contractor

Build stronger pricing discipline as teams, projects, indirect cost layers, and service offerings grow more complex.

Enterprise / Multi-Layer Organization

Gain clearer visibility into support functions, reporting defensibility, hybrid revenue streams, and the larger indirect infrastructure shaping final price.

The core principle stays the same at every level: profit becomes more reliable when cost reality is modeled first instead of assumed. A smaller contractor may need better recovery of hidden time. A larger enterprise may need better separation of burden, support structure, operations, and revenue channels. In both cases, breakeven comes first.

Profit Becomes Predictable When Cost Truth Comes First

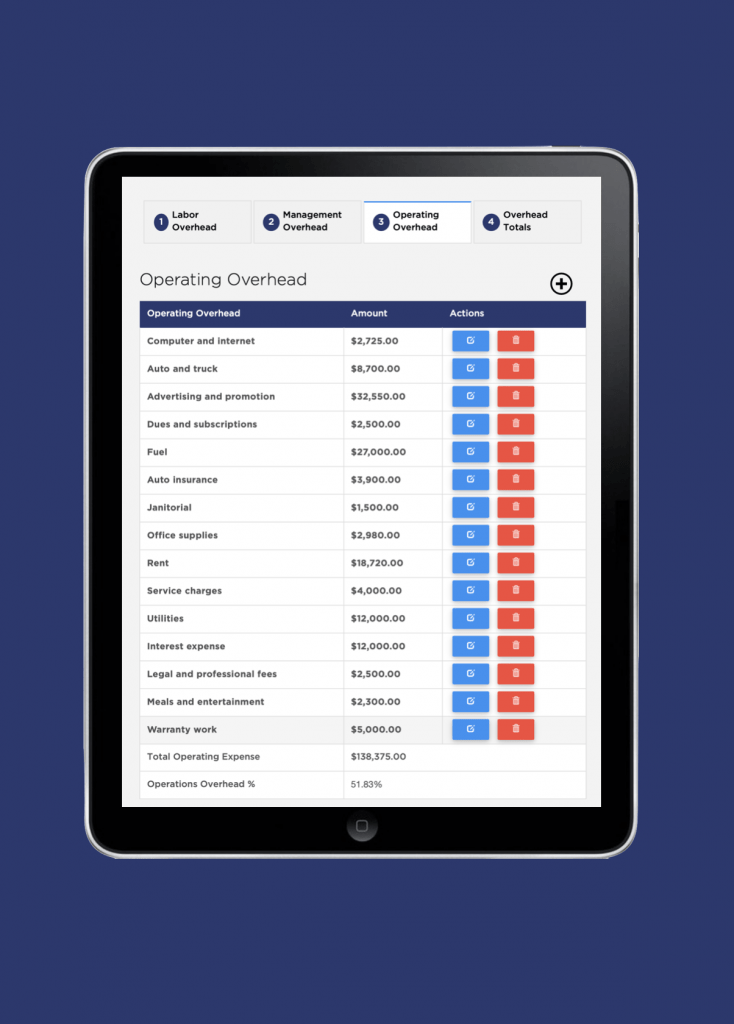

BreakEven PLUS™ is designed for environments where labor burden, indirect load, pass-through cost, and pricing discipline all matter. Rather than treating profit as a final spreadsheet row, the platform models the full labor cost stack first and then shows profit by source, by expression, and by impact before a price is ever submitted.

This supports private commercial work, public and infrastructure contracts, federal and regulated environments, and indirect-heavy construction where the full cost stack must be seen clearly before price decisions are made. It also reduces the dependency many companies develop on repeated consulting cycles every time reporting needs to change. Instead, teams gain more clarity and transparency in real time.

Why Accurate Cost Recovery Helps Increase Construction Profits

In many estimating environments, profit is treated like a single line at the end of a spreadsheet. That creates the illusion of visibility without showing what is actually driving the result. Leadership may see the total, but not the sources holding margin together or quietly damaging it underneath.

  • True gain on labor is often unknown
  • Burden and fringe may be under-recovered
  • Overhead and operations can be blurred together
  • G&A is often applied without enough context
  • Pass-through activity may distort margin interpretation
  • Hybrid companies may confuse different revenue streams
  • Markup changes may not be tied to downstream estimating logic
  • Decision-makers see totals but not the cost logic underneath

When profit is built on top of an incomplete cost stack, it becomes harder to explain, harder to defend, and harder to manage. The number may be there, but confidence in the number is not. That is exactly why better cost recovery helps increase construction profits in a more durable way.

The BreakEven PLUS™ / FALIB® Solution

BreakEven PLUS™ calculates and displays profit in multiple dimensions so there is far less ambiguity. Instead of implying profit from a final total, FALIB® renders it explicitly from the modeled cost structure underneath. That helps contractors, estimators, and executives understand what is actually holding profit together before price is submitted.

Labor Profit

Visible as markup, margin, dollars, and per-hour contribution.

Pass-Through Profit

Separated clearly so support-driven revenue is not buried inside blended assumptions.

Combined View

Integrated across modeled sources for a more complete profit picture.

Defensible Logic

Tied back to cost structure instead of appended after the fact.

Labor Profit Is Exposed, Not Assumed

BreakEven PLUS™ shows labor profit as its own modeled result. That allows users to understand how labor pricing contributes to the final outcome without confusing it with pass-through activity or blended assumptions.

Labor Profit Markup (%)

See the markup expression applied to labor and understand how it contributes to pricing structure.

Labor Profit Margin (%)

View labor contribution as a margin result instead of relying on markup alone.

Labor Profit Dollar Amount

Translate labor pricing decisions into real dollar visibility instead of percentage-only interpretation.

Labor Profit Per Hour

Understand labor contribution on an hourly basis for clearer sell-rate and productivity decisions.

Increase Construction Profits Across Sold Labor and Pass-Through Support

BreakEven PLUS™ is not only useful for specialty subcontractors selling their own labor. It also supports general contractors and hybrid businesses that recover labor tied to pass-through execution, vendor coordination, and project support. Those support hours still require burden, fringe, overhead, operations, and broader business structure to sustain them.

That means a contractor can increase construction profits not only by pricing sold labor correctly, but also by differentiating pass-through support revenue streams more clearly. FALIB® helps show where those revenue streams should be separated so the right cost logic can be applied to the right work path.

Markup Changes Should Flow Through the Estimating Stack

The real value is not just seeing a different markup percentage on a report. The value is understanding how that markup change affects the hourly sell rate and then flows through the broader estimating stack. When the user updates desired profit markup per hour and saves it, that change can affect the unit pricing logic used across service items and production assemblies within estimating.

This matters because users should not have to rebuild every estimate manually every time profit strategy changes. Once the desired markup is saved, downstream pricing can refresh more efficiently through the assembly structure. That can apply to sold labor and also to pass-through support hours used to sustain subcontracted execution. This is one of the practical ways better modeling helps increase construction profits across real bidding environments.

Side-by-Side Comparison: Hourly Sell Rate Before and After a Markup Change

This is not meant to be a one-off markup example. It is a comparison that shows how changing profit markup affects labor profit per hour and hourly sell rate while the underlying breakeven structure remains intact. In practice, this kind of change can support broader updates inside the estimating stack after save.

Swipe sideways to view the full comparison tables

Sold Labor Revenue Stream

Primarily self-performed labor. Often relevant for specialty contractors and self-performing operations.

Hourly Sell Rate $80.97
Component Percentage (%) Hourly Rate ($)
Base labor (Direct)31.86
Burden and Fringe (Direct)62.4819.90
Overhead (OH – includes Ops OCC)10.773.43
General & Administrative (G&A)23.727.56
Internal Research & Development (IR&D)12.744.06
Bid & Proposal (B&P)0.930.30
Occupancy (OCC - G&A Portion)0.370.12
BreakEven RATE111.0167.22
Profit markup (11.11%)11.117.47
Cost of Money *GovCon0.30
Hourly Sell Rate80.97

Sold Labor Revenue Stream

Same breakeven path, but with profit markup increased to show how the sell rate changes.

Hourly Sell Rate $83.59
Component Percentage (%) Hourly Rate ($)
Base labor (Direct)31.86
Burden and Fringe (Direct)62.4819.90
Overhead (OH – includes Ops OCC)10.773.43
General & Administrative (G&A)23.727.56
Internal Research & Development (IR&D)12.744.06
Bid & Proposal (B&P)0.930.30
Occupancy (OCC - G&A Portion)0.370.12
BreakEven RATE111.0167.22
Profit markup (15.00%)15.0010.08
Cost of Money *GovCon0.30
Hourly Sell Rate83.59
Markup Change 11.11% → 15.00%
Labor Profit / Hr Change $7.47 → $10.08
Sell Rate Change $80.97 → $83.59

Illustrative comparison. This side-by-side view helps increase construction profits by showing how markup changes affect hourly sell rate and downstream estimating logic without changing the underlying breakeven structure first.

Pass-Through Support Revenue Stream Matters Too

Some companies are hybrid businesses. They may sell their own labor in certain situations while also recovering support-oriented labor tied to subcontracted or pass-through execution in others. Those are not always the same revenue path, and they should not always be priced as though they are.

Swipe sideways to view the full table
Component Percentage (%) Hourly Rate ($)
Base labor (Direct)28.75
Burden and Fringe (Direct)62.4817.96
Overhead (OH – includes Ops OCC)56.5816.27
General & Administrative (G&A)83.4724.00
Internal Research & Development (IR&D)44.9412.92
Bid & Proposal (B&P)21.896.29
Occupancy (OCC - G&A Portion)2.990.86
BreakEven RATE272.36107.04
Cost of Money *GovCon0.96
Hourly Labor Rate116.56

This separate support-oriented rate path can be especially relevant for general contractors. In those environments, labor and indirect support may help sustain subcontracted execution rather than only self-performed production. Recovering that structure correctly supports project oversight, coordination, vendor administration, and broader operational burden that still belongs to the contractor’s business model.

Hybrid contractors can increase construction profits when sold labor and pass-through support revenue streams are modeled separately. FALIB® helps distinguish those paths more clearly so burden, fringe, overhead, operations, G&A, and profit can be applied more appropriately to each revenue stream.

Why This Impacts Profits on Construction Jobs

Every construction job depends on recovering more than direct labor alone. Burden, fringe, overhead, operations, G&A, and the full breakeven structure all shape whether the work is truly profitable. If any one of those elements is understated or blended poorly, the final price may look acceptable on paper while still under-recovering the actual cost structure of the business.

That becomes even more important when bidding from an estimating stack with service items, assemblies, labor-driven production assumptions, and multiple revenue paths. If profit markup changes are easy to save and those changes automatically refresh downstream pricing logic, the office can respond faster and with more consistency. That supports more disciplined estimating, clearer sell rates, and stronger protection of profits before the bid goes out.

BreakEven PLUS™ and FALIB® help increase construction profits by making cost truth visible before price decisions are finalized. Instead of discovering margin problems later in the field, teams can see the structure holding profit together before the work is priced.

Increase construction profits through better labor cost recovery
Small contractors, growing teams, and enterprise organizations all need clearer recovery of indirect time, support effort, and pricing logic.
Construction estimating strategy to increase construction profits
When profit markup changes can flow through the estimating stack, teams gain a faster and more disciplined way to update bids and unit pricing.

Related SERVVIAN® Resources

Explore more SERVVIAN® resources that support breakeven visibility, cost structure clarity, pricing discipline, and contractor profitability. Without a fully structured breakeven, pricing is not a strategy — it is a risk.

For deeper definitions, go straight into the SERVVIAN® glossary search:

Additional Industry Context

For broader industry context, readers can also review information from the Associated General Contractors of America and U.S. Census construction data. Those outbound resources help place cost recovery, construction demand, and contractor conditions into a wider market context.

Follow SERVVIAN® on Social Media

Stay connected for more content on estimating precision, breakeven visibility, labor economics, and pricing discipline.

⚠ Disclaimer: FALIB® reports are based on forecasted labor, operational costs, pass-through components, and other cost estimates entered by the end-user, and should not be interpreted as incurred cost actuals. Profit visibility and profit predictability in FALIB® refer to modeled forecast outcomes — not realized or audited financial results. Profit outputs in FALIB® represent projected conditions derived from user-provided inputs and do not constitute evidence of actual earnings, final contract performance, or accounting actuals.
